Upcoming Park Projects

This page is intended to give updates of major Suisun City Park Projects in development.  For specific questions, contact Marvin Mora, Management Analyst II, at mmora@suisun.com

Prosperity Garden Park
1740439906273-fd81de04-072d-4765-9ccb-d4d2f096b438_1.jpg491842426_1545097849759477_334486382781755014_n.jpg

Prosperity Garden Park will be located on a City owned 1.9 acre lot west of Blossom Ave along the canal of Laurel Creek. Project will consist of a community garden along with a mini-park with recreation features at its entryway. Features include a secure perimeter, a vegetative screen to protect adjacent homes, restrooms, storage area, & rentable plots and raised beds.

Budget

Total Project Cost = $1,918,243

  • American Rescue Plan Act (ARPA) Funding  - $375,000
  • CA Department of Parks and Recreation ‘Specified Grant’ Funding - $780,000
  • Suisun City Park Development Funds - $762,243
Update – 4/18/25

Construction Contractor WABO Landscape and Construction resumed work on the site on 3/27/25.  All structures and fixtures have been delivered to the project site, and the monoslope shade structure, restroom, and entrance sign are now up!  Project completion is expected for June 2025.  Grand Opening event will be scheduled once timeline is verified and once closer to the completion date.

Sustainable Solano (SuSol) is also assisting Suisun City RPM Department with community garden outreach, construction and implementation of community garden rules, and meaningful education programs.  SuSol is holding focus group meetings at the Suisun City Library, with the next one scheduled for Tuesday, 4/29 at 6pm.



Montebello Vista Park Revitalization

Phasing Plan.jpg

This project will feature the conversion of the grass playing field into a synthetic field surface, facility inclusive of restroom, snack bar, and storage, and new shade structure near the playground area.

Budget

Total Project Cost – $2,424,363

  • CA Department of Parks and Recreation ‘Specified Grant’ Funding - $1,720,000
  • Suisun City Park Development Funds - $704,363
Update – 4/18/25

Project is nearing end of design phase. City is still awaiting 90% Construction Documents from design contractor Melton Design Group.  Project has frayed a bit from contractor's proposed timeline, but project is still expected go out to bid for construction in June, and is expected to be complete by the end of October 2025.  The project will be completed well before grant funding expires in June 2026.



Heritage Park Enhancement

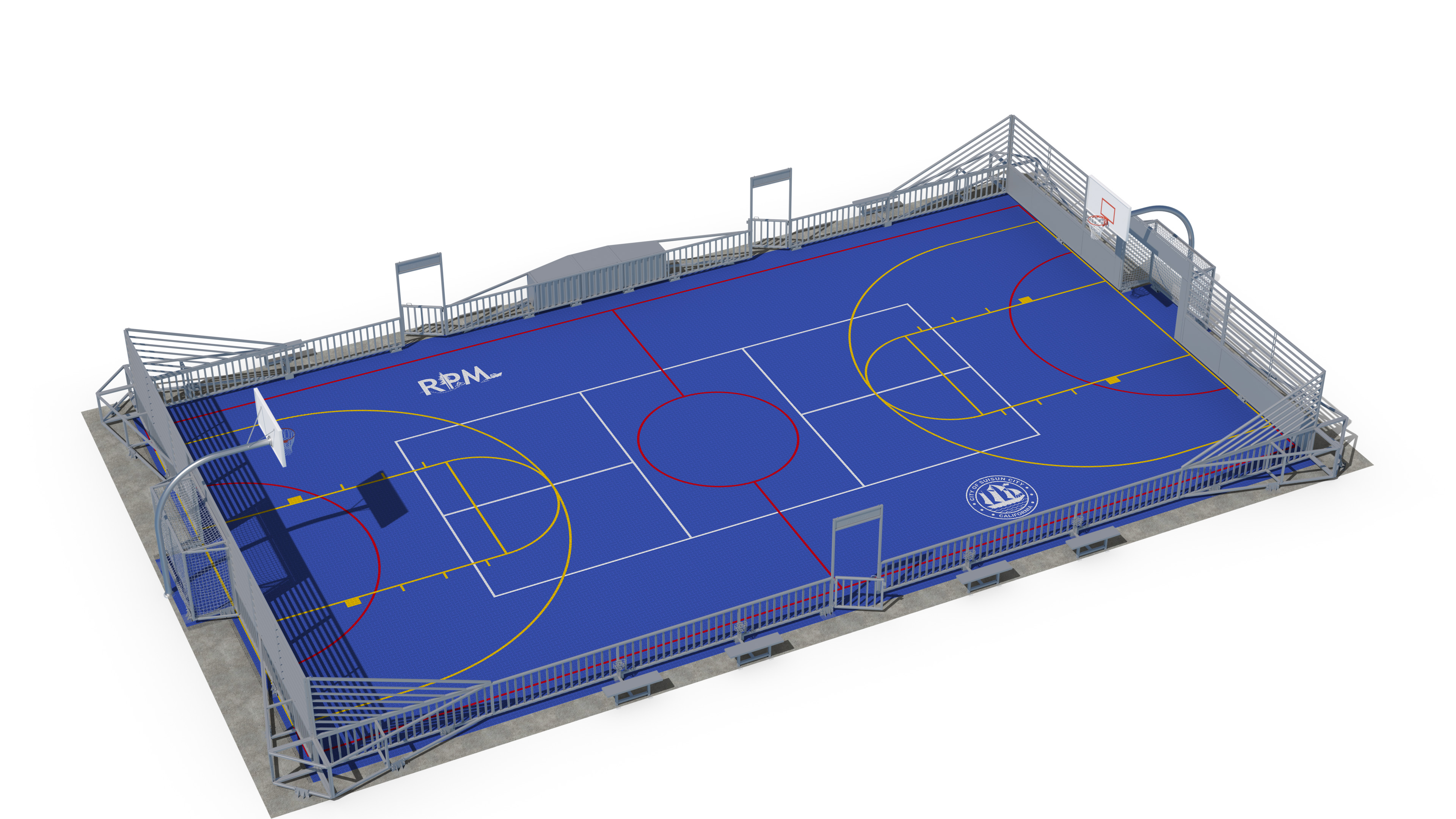

Project will include the rehabilitation of the existing basketball court surface, the addition of a multi-sport court, and the construction of a covered picnic pavilion.  The mini-pitch is funded through funding from the National Recreation and Park Association's Youth Sports Equity Grant Program.

Budget

Estimated Total Project Cost – $800,000

  • Project fully funded through Park Development Funds
Update – 4/18/25

Project is also nearing end of design phase. Design firm GSM Landscape Architects has submitted 90% Construction Documents to the City for approval, and project team is aiming to bring final design and budget for RPMA Commission recommendation and City Council approval in May 2025.  Barring any unforeseen circumstances, project is expected to be complete by October 2025.
